A couple of months ago I talked about a kanban for personal management. This concept had two desirable elements:
1) Visualizing your work
2) Limiting your work.
In my previous visual task board I found prioritization meaningless. Tasks are either important or not. If it is important then put it on the list. If not then don't waste time or space pretending that you'll get to it, because you won't.
Dan Markovitz from TimeBack Management and I had several discussions on the set-up of a personal kanban. We discussed how to determine the size of WIP. The WIP limit shouldn't be determined by the number of items, because one large task/project consumes as much time (which is your critical resource) as eight small tasks. Unlike a production line where the cycle time is both known and constant, knowledge work is inherently more variable. So it's tough to determine the appropriate WIP level.
We also talked about using the calendar as kanban. By designating dates and times for specific tasks and projects, you've essentially created a production schedule for your work, with the calendar (and the calendar alerts) acting as a kanban that pulls work forward.
I decided to try to create my own kanban system following these steps:
1) Establish Your Value Stream – The flow of work I chose was Backlog, This Week, Today, and Done.
2) Establish Your Backlog – I put every task onto a post-it-note, if the task had a due date I put that on the note as well.
3) Establish Your WIP Limit – I limited my Today column to 3 (good place to start) and therefore limited my This Week column to 15
4) Begin to Pull – I moved tasks into the next two columns and got to work.

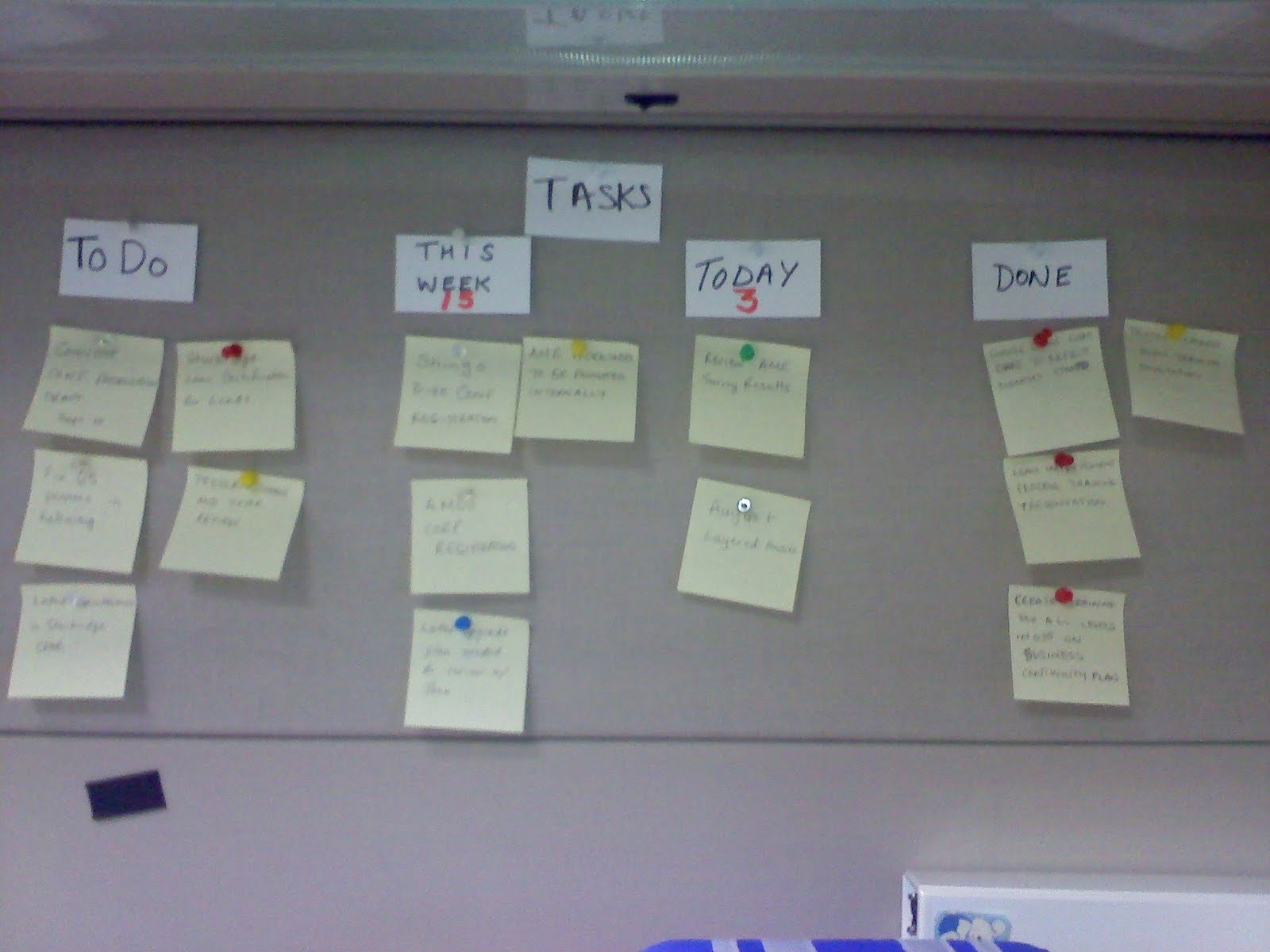

Below you can see the result on my new kanban:
I have been using my kanban system for a little while and I want to share some things I have learned thus far:
1) For really small tasks I still keep a todo list with paper and pen.
2) This Week column allows me to plan out my week.
3) A WIP of 3 has been working for me for tasks around 1-2 hours in length.
4) The size of the task is not too important. Smaller tasks make you pull faster. For larger tasks I try to break them up into workable chunks.
5) The current board is not portable which I need.
6) Adding color to this system would help distinguish different types of tasks.
While looking at various ways to improve my kanban system I came across this presentation on kanban designs the inspire flow.
In the next version of my kanban I will attempt to address some of the previous short comings. Just as in Kaizen in your organization, having tried a quick and easy manual version of this kanban I found what works and what doesn't. Now making those improvements will be even easier.
